1 Advent
The development sector, like many different sectors, is surrounded by way of uncertainty as a result of each lengthy efficiency sessions and the involvement of more than a few individuals, thus implying extra adverse dangers. The luck or failure of any undertaking might be measured in the course of the fulfilment of its targets, the affect at the events and customers’ delight, amongst different dimensions. On the other hand, luck is outlined by way of handing over a high quality undertaking inside the funds and agenda established.
Price and time deviations in building tasks represent a global downside for the development sector. Many works don’t seem to be completed as deliberate. Flyvbjerg et al. (2002) confirmed this facet of their learn about on price underestimation in 20 nations in 5 continents. Price overruns happen in 9 out of each 10 main building tasks. On this regard, Cantarelli et al. (2012) said that price overruns are a world phenomenon, however the measurement varies in keeping with the positioning. KPMG (2015) reported that simplest 31% of the tasks analysed completed with deviations not up to 10% of the preliminary funds. The remainder 69% offered excesses between 10% and 50%, while simplest 25% of tasks fulfilled the agenda established. Al-Nahhas et al. (2024) point out that sure building tasks in extremely evolved nations succeed in price overruns between 16% and 95%. When it comes to infrastructure tasks, the creator states that during sure creating nations the fee overruns are between 70% and 200%. This reasons taxpayers to need to pay upper bills for services and products related to those tasks. For the creator, it is very important to entirely assess and analyse dangers, in addition to enforce chance control plans. For Chen et al. (2023), the hazards that come from the complexity of infrastructure tasks have led to funds overruns around the globe, having a considerable affect on economies. Ammar et al. (2023) learn about undertaking price overruns and point out that contingency reserves are in most cases applied to handle such dangers and uncertainties, with chance control on this context being one of the crucial essential jobs of planners. The issue additionally exists with admire to the compliance with transient time limits in tasks, the issue additionally exists. Gurgun et al. (2024) signifies that finishing tasks on time is extensively thought to be probably the most biggest signs of undertaking luck. On this regard, they argue that in spite of technological advances within the present technology of digitalisation, within the building sector there may be nonetheless a deficient lead to compliance with schedules. For the authors, the explanations for this circumstance require investigation.
In keeping with the Venture Control Institute (2017), chance is any unsure tournament that, if it occurs, impacts a minimum of one undertaking function. A number of elements may just have an effect on the fulfilment of targets, various as a result of the field, the geographic setting, and the undertaking’s traits. Because of this, dangers must be assessed in all works to ensure luck. Of their learn about on dangers in energy plant tasks, Islam, Nepal and Skitmore (2023) confer with the significance of learning the precise dangers of a particular nation or geographic setting. Possibility control is the method of figuring out, analysing, responding making plans, reaction implementation, and tracking undertaking dangers (Venture Control Institute, 2017). Possibility control is a very powerful to be thought to be as a self-discipline inside of undertaking control to reach luck. It’s aimed toward each bettering efficiency and contributing to the fulfilment of targets by way of decreasing threats and by way of expanding alternatives.
Possibility control has been required since precedent days, however the first analysis research within the development sector emerged within the mid of the 20 th century (Taroun, 2014). In keeping with Flanagan and Norman (1993), dangers had been controlled within the development sector because the final two a long time. Baloi and Value (2003) indicated that the chance control ways according to statistical fashions are seldom utilized in follow by way of contractors. De Camprieu et al. (2007) additionally confirmed the loss of making use of this kind of fashions. Additionally, Taroun (2014) reviewed the ways used to control dangers in contemporary a long time and said that there’s a vital hole between the idea and the use in follow of those ways. Thus, chance control is an invaluable device that gives advantages and avoids issues; on the other hand, it must be extra studied.
On this analysis, dangers are occasions that may have an effect on the fee and time goals of the undertaking. Inside the chance control procedure, this analysis is aimed toward creating the chance identity degree in building tasks within the Dominican Republic. In keeping with the Banco Mundial (2020), the Dominican Republic’s economic system is one of the Latin The united states’s upper expansion economies, with an annual reasonable of 6.3% between 2014 and 2018. In 2019, the gross home product (GDP) larger by way of 5.1%, the perfect in Latin The united states, corresponding 12% of the GDP to the development sector. Additionally, this sector has performed a a very powerful function within the expansion of the carrier sector within the nation. This analysis could also be aimed toward figuring out the significance degree of chance elements in the case of each the fee and time objective and its dating with the events, thus offering undertaking managers with helpful data to take on with them.
To spot those dangers, each the prevailing literature has been exhaustively reviewed and influential elements had been indexed. The literature overview was once performed the use of Scopus, Internet of Science, and Google Student as primary search engines like google and yahoo. Those dangers had been assessed by way of more than a few execs of the field via a survey according to two attributes: prevalence chance and affect. The knowledge received have been used to categorise the intense chance elements, thus figuring out their affect at the following facets: (i) price and time targets, (ii) the degree through which chance elements happen, and (iii) the brokers liable for those chance elements.
2 Literature overview
Price and time deviations, along with their reasons in tasks, had been extensively studied in more than a few spaces of the development sector, specifically because the Eighties. Those research are principally according to questionnaire surveys focused on execs of the field.
As well as, there’s a international distribution of the territorial contexts the place those research have been performed. The territorial scale is every so often very huge. Flyvbjerg et al. (2002) studied the fee overruns of 258 tasks in 5 continents, principally that specialize in Asia and Africa. Alternatively, there are extra diminished scopes, corresponding to that during Ahmed et al. (2003), which recognized the principle lengthen reasons within the development sector when development buildings in Florida. Additionally Enshassi et al. (2009) studied the lengthen and price overrun reasons within the building tasks within the Gaza Strip.
There are lots of chance elements which range in keeping with each the traits of the undertaking and the geographic scope analysed. On the other hand, there also are basic dangers, as Zou et al. (2007) confirmed by way of evaluating elements between Australia and China. Desk 1 comprises probably the most wired chance elements in literature and summarises the research figuring out them. Those elements also are understood as assets of chance, this is, unsure occasions that, in the event that they happen, can have an effect on the goals of the tasks.

Desk 1. Major chance elements influencing building tasks.
Price and time chance elements are in most cases recognized and analysed in huge tasks (excessive funds and complexity) belonging to each the general public and civil engineering sector. A few of these research simplest thought to be the chance at the price objective (Akinci and Fischer, 1998) or at the time objective ((Ogunlana et al., 1996; Al-Momani, 2000)). Others, corresponding to Kaming et al. (1997), Frimpong et al. (2003), Le-Hoai et al. (2008) and Al-Hazim et al. (2017)), studied the hazards affecting each targets, prevailing the research on price elements. There have been additionally different standards in keeping with the character of the chance, its supply or beginning, or the undertaking degree the place the chance takes position.
Maximum analysis research are qualitative and are according to the pros’ revel in and judgement. Surveys, questionnaires, and interviews are used as equipment for information acquisition. As well as, more than a few strategies are used to analyse the results of the chance elements: (i) Assaf and Al-Hejji (2006) and Le-Hoai et al. (2008) used the frequency index, the severity index, and the significance index; (ii) Chan and Kumaraswamy (1997) and Frimpong et al. (2003) used the relative significance index (RII); (iii) Bubshait & AL-Juwairah (2002) used the severity index; and (iv) Zou et al. (2007) used the importance index.
Nonetheless, there are few research targeted at the chance control in Latin The united states, specifically at the elements of price and time deviations within the building tasks of probably the most economies with the most efficient indexes in recent times: the Dominican Republic. Senior and Rodríguez (2012) analysed the limitations to fortify productiveness (the learn about was once according to surveys focused on 134 execs of the development sector), and Martínez et al. (2016) performed a piece for the Technological Institute of Santo Domingo at the key elements required for the development building of that town to achieve success.
Realizing the criteria that reason price overruns will increase the effectiveness of price keep an eye on, so steady researching and the diversification of research in this factor all the way through time and in more than a few geographic context are a very powerful. The aid of price and time will increase could also be a few of the primary demanding situations to be triumph over by way of the events of a undertaking.
On this paintings, a central analysis query is proposed: What are the precise dangers that may negatively affect the fee and time of building tasks within the Dominican Republic? To respond to it, we recommend the target of creating the degree of identity of the ones occasions that can have an effect on the fee and closing date of building tasks on this geographical house. The undertaking chance control procedure is in most cases made up of the levels of identity, research, tracking, and keep an eye on. On this method, it’s meant to give a contribution, the use of those ways, to bettering undertaking control. The technique adopted within the analysis is described beneath.
3 Method
3.1 Acquiring the initial listing of chance elements
After analysing the references, a complete of 135 chance elements affecting the time and price targets in building tasks have been to start with received. As defined beneath, this set of things was once subjected to a primary refinement procedure and therefore to a pilot survey. After this procedure, the overall listing of things was once received, which was once the topic of professional surveys.
Possibility elements associated with this analysis have been taken from all references all the way through the overview procedure. Each and every time an element was once discovered that was once thought to be to confer with the similar idea or was once even named in the similar method, some extent was once added to the depend. A few of these elements have been identical, which is one thing same old when the use of more than a few references; on the other hand, the objective on this first degree was once according to figuring out as many chance elements as imaginable. The danger elements with the perfect issues within the depend have been as follows: (i) undertaking financing issues/loss of sources/means of financing/proprietor incapable of dealing with the commercial load of the undertaking, with 23 issues; (ii) design diversifications, with 22 issues; (iii) environmental/local weather stipulations, with 21 issues; (iv) diversifications by way of the customer/requests for converting undertaking necessities or definitions, with 20 issues; and (v) incomplete, vague or irrelevant price estimate/flawed estimate means, with 19 issues. Alternatively, more than a few elements received only one level within the depend: (i) govt paperwork in proprietor organizations, (ii) sluggish change of documentation amongst individuals, (iii) employee’s nationality, and (iv) agenda restriction to hold out actions.
The following degree consisted in bettering the preliminary listing with the 135 chance elements, which have been analysed making an allowance for a number of facets. Thus, sure elements associated with identical ideas or the ones discussed an unclear, ambiguous, or contradictory method have been got rid of. As well as, the ones thought to be insignificant as they received only one level within the repetition depend have been additionally got rid of. After this 2nd degree, the preliminary listing went from 135 to 71 chance elements. In a 3rd degree, a pilot survey was once performed, thus decreasing once more the listing to 56 chance elements, which have been then assessed by way of a panel of professionals.

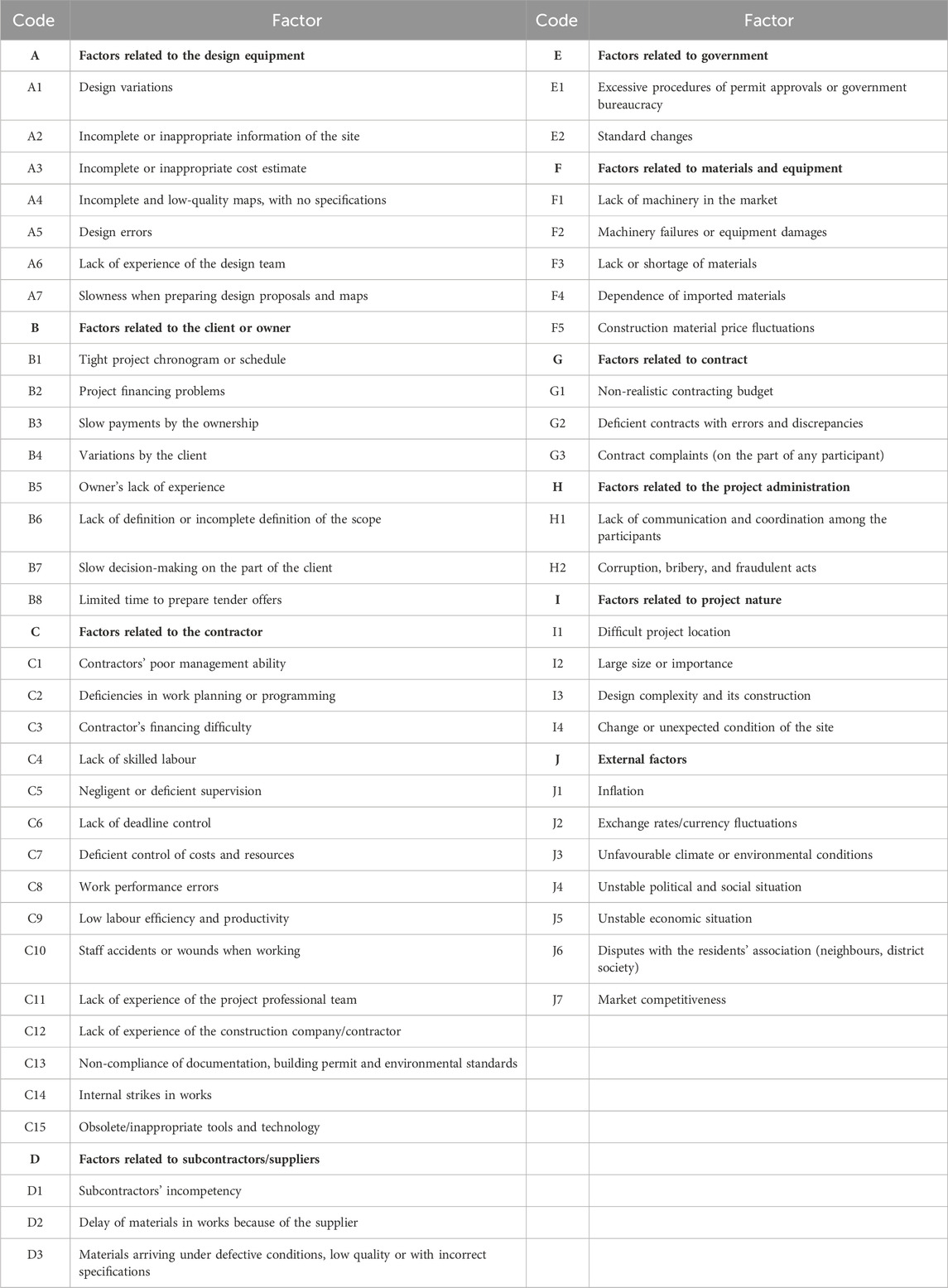

After analysing and bettering the listing, the chance elements have been categorized and organised in homogeneous teams. A number of tactics of classification have been thought to be, corresponding to that offered by way of Zou et al. (2007) associated with the events of the undertaking. Alternatively, Assaf and Al-Hejji (2006) mixed the events with different chance assets, together with design, exterior elements, fabrics or apparatus. In spite of everything, the criterion by way of Garcia Casares (2015) was once followed because it offers with the issue beginning. Thus, a suite of 71 gadgets have been in the past established and once more progressed after a pilot survey. The criteria have been ultimately grouped in numerous blocks: (i) design apparatus, (ii) shopper, (iii) contractor, (iv) subcontractors and providers, (v) govt, (vi) fabrics and kit, (vii) contract, (viii) undertaking management or control, (ix) undertaking’s personal elements, and (x) exterior elements.
3.2 Possibility modelling
The method of acquiring the overall degree of a chance, this is, chance modelling, is in most cases thought to be as a mixture of the chance of its prevalence and its penalties (ISO, 2018). Taroun (2014) said that the combo of chance with affect as the results of each prevails in analysis research to fashion the chance.
For the professionals’ exams of the chance of the chance and its affect at the time and price targets of the more than a few elements, a scale very similar to the Likert scale however with 6 ranges was once equipped. The size comprises 6 values: 0.50 = nearly null; 1 = very bathroom toilet; 2 = low; 3 = reasonable; 4 = excessive; and 5 = very excessive. Two questions have been incorporated in a single segment, independently of the exams: one query was once according to the issue that are supposed to be got rid of from the listing, and some other at the comfort of together with every other issue that might indicate delays and building up prices in a undertaking. Those two questions have been open-ended questions. Some other segment incorporated two questions aimed toward understanding the state of the chance control procedure within the Dominican Republic. On this case, the guidelines required was once the frequency of the use of chance control within the tasks through which the professional has participated, in addition to the equipment they knew or had used for the duty.
To analyse the values received, the reaction choices of the size used have been related to numeric values. For this, the size indicated by way of the Venture Control Institute (Venture Control Institute, 2017) was once used as a place to begin, the place the chance worth adopts a variety between 0.10 and nil.90 and the affect vary between 0.05 and nil.80. The levels utilized in our analysis come with the chance values of 0.05 and the affect worth of 0.025, similar to the virtually null worth (0.5) of the overview scale. Desk 2 comprises the values followed.

Desk 2. Equivalence of professionals’ exams scale with numerical scale of chance and affect.
After acquiring the chance and affect values, those values have been mixed to procure the importance ranking of each and every chance (
The place
The following calculation was once to procure the typical ranking for each and every chance (Eq. 2). This reasonable ranking was once referred to as in Zou et al. (2007) as “chance importance index ranking”. It was once used to categorise all dangers, each for the fee and time objective.
The place
To procure severity ranges of the hazards expressed at a qualitative degree according to the chance importance indexes calculated, the matrix from Determine 1 was once used. This matrix is according to that indicated by way of the Venture Control Institute (2017), being tailored to the 6 imaginable chance and affect values. The matrix was once divided into 4 zones in keeping with their importance index for the fee and time targets of the undertaking. Values may just succeed in 4 chance ranges: “Very low,” “Low,” “Medium,” and “Top.”

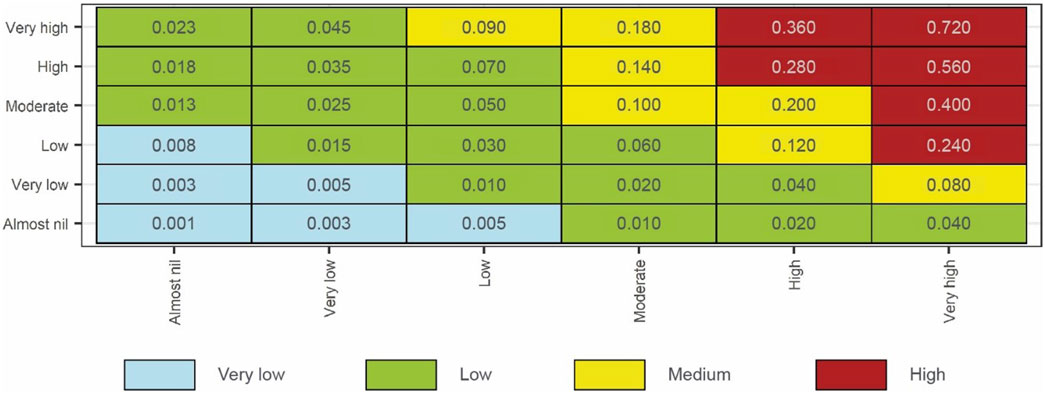

Determine 1. Possibility severity matrix.
3.3 Pilot survey and development of the listing of chance elements
Surveys have been addressed to a panel of professionals. A pilot take a look at was once in the past performed to incorporate within the process the changes required ahead of sending it to the individuals. The survey was once expedited the use of on Google Bureaucracy and was once divided into 4 blocks and 14 sections, as Desk 3 displays. The survey was once configured to a reaction by way of each and every respondent via a mandatory login however closing nameless. All questions have been outlined within the questionnaire as obligatory to take away the mistake of no solution.

Desk 3. Construction of the survey.
Block 1 consists of 6 questions aimed toward acquiring data at the respondent’s skilled profile. Those questions are closed questions, with a number of reaction choices. Block 2 displays the listing containing the 71 chance elements in the past recognized in each the literature overview and the primary progressed degree. Components have been grouped in 10 classification classes, each and every fascinated by a piece. For each and every chance issue, the professionals assessed 3 variables: (i) prevalence chance of the issue; (ii) affect at the price objective of the undertaking if the issue takes position; and (iii) affect at the time objective of the undertaking if the issue takes position.
A complete of 10 execs have been decided on for the pilot surveys, however 7 of them took section in it. The college stage is engineering for six of the individuals and one architect. The pro profile of engineers is that of undertaking supervisor, building manager, and contractor, and at the a part of the architect that of clothier. Each and every respondent was once in my opinion mentioned with their basic opinion at the survey and at the chance elements that gave the impression complicated and obscure. Contributors on this pilot take a look at have been surveyed at the delicate listing of 71 chance elements with the price scales and technique described above. After having the knowledge from the overview within the pilot take a look at, the criteria have been organised in keeping with the values received within the importance index for the time and price targets. Semi-structured interviews are then held with the individuals within the pilot survey. The target of those interviews was once to procure complementary data helpful for the overall design of the survey. Thus, added difficulties when creating the process or elements which have been puzzled or obscure have been detected. Knowledge cleansing was once additionally performed, the criteria with the bottom ranking have been analysed to decide in the event that they must be got rid of from the listing and the explanations, so the criteria with the bottom ranking have been got rid of, in addition to the ones thought to be doubled as a result of their similarity with others. After those changes, the listing was once diminished to the 56 elements indicated in Desk 4, which have been incorporated within the particular survey.

Desk 4. Importance index for time and price targets.
3.4 Surveys for the panel of professionals
On this degree of the analysis, surveys are performed with the crowd of professionals. To spot the panel of individuals, intentional sampling was once performed. The panel of professionals was once shaped via skilled colleagues from the analysis crew within the Dominican Republic. Those colleagues, in flip, equipped different new execs who met the established necessities to be a part of the crowd of respondents. Probably the most necessities was once to have a professional skilled profile associated with the development sector, engineers and/or architects, or different similar topics. The second one requirement was once to have at least 5 years of labor revel in within the public or non-public building sector within the Dominican Republic. In overall, 86 execs have been recognized to whom the survey was once despatched electronically. The survey is created and disbursed the use of Google Bureaucracy. 47 responses have been won to the shape, of which 6 have been eradicated as a result of they offered the similar solution to all of the questions. The remainder 41 surveys constitute a reaction charge of 47%, which is thought of as appropriate in keeping with Zou et al. (2007). The pro profile of the respondents, received from the primary block of the survey, is proven in Desk 5.

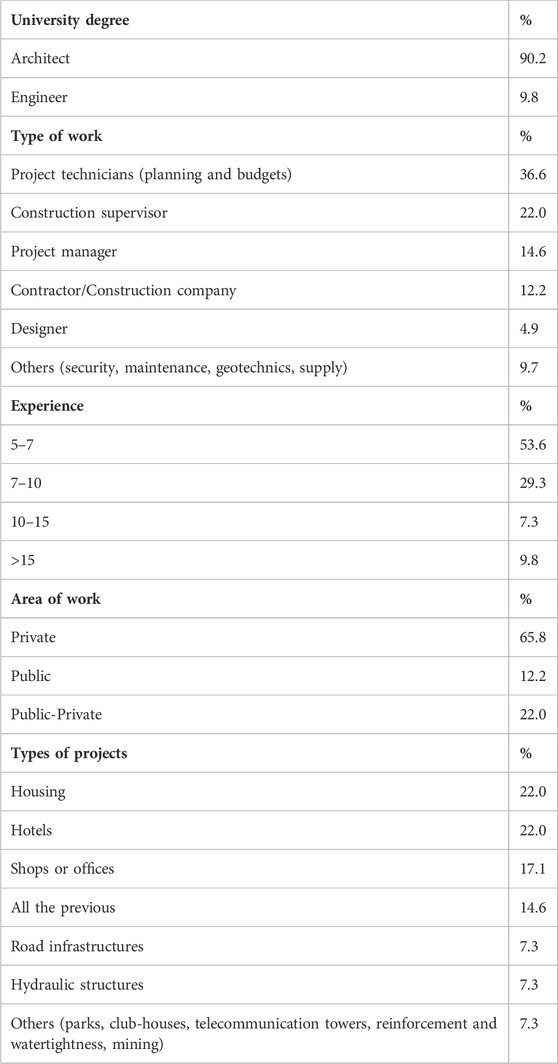

Desk 5. Respondents’ skilled profile.
4 Effects and interpretation
4.1 Possibility degree of the criteria
Knowledge from surveys have been accumulated and analysed. The purpose was once to spot the intense elements for each targets and to decide dispositions, similarities, and diversifications within the effects. In the second one block of the survey, the individuals assessed the chance and prevalence, in addition to the affect at the 56 elements. Those elements have been categorized within the 10 teams in the past discussed. After acquiring the values, chance and affect have been mixed. The importance of each and every chance was once received by way of making use of Eq. 1, and the importance index that signifies the severity degree of each and every chance was once received with Eq. 2. Determine 2 displays the price distribution of the importance index for each and every issue, each for the fee and time objective.

Determine 2. Field plots with the values of the importance indexes for the fee (ISC) and time objective (IST).
Determine 2 displays the criteria with the best importance index. Generally, the indexes with the best values (between 0.20 and nil.30) and repeated in each targets constituted the intense chance elements: (i) A1-Design diversifications; (ii) B4-Permutations by way of the customer; (iii) B1-Tight undertaking chronogram or agenda; (iv) B8-Restricted time to arrange gentle provides; (v) C2-Deficiencies in paintings making plans or programming; (vi) C4-Loss of professional labour; and (vii) C8-Paintings efficiency mistakes.
Afterwards, the severity matrix of the chance (Determine 1) was once used because it grew to become the numerical importance index values right into a scale of severity degree of the chance qualitatively expressed. Thus, maximum critical elements reached a “Top” chance degree, i.e., numerical importance index values between 0.20 and nil.30 have been reached. On this regard, Desk 6 displays the chance ranges accomplished by way of the 56 elements.

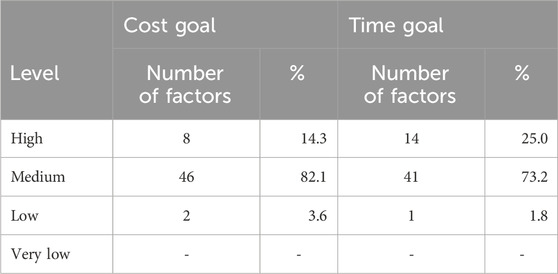

Desk 6. Possibility degree of the criteria.
The effects confirmed extra elements with a “Top” degree for the time objective. The danger perceived was once due to this fact higher for the time objective than for the fee objective. Determine 3 displays this facet, together with a radar graph for each and every crew of chance elements. The graphs constitute the importance indexes in the case of the fee (ISC) and time (IST) of the more than a few elements, constituting a better graphic floor of dangers for the time objective. As well as, critical elements, i.e., the ones reaching importance index values between 0.20 and nil.30, have been repeated each for the time and objective (A1, B1, B4, B8, C2, C4, and C8). Alternatively, there was once no issue on the “Very low” chance degree in any of the targets. Thus, all of the dangers incorporated within the listing must be imagine within the building tasks. Determine 3 additionally displays that the chance assets concentrating extra critical dangers have been crew C (contractor) and B (shopper), with higher graphic surfaces of dangers than the opposite teams.

Determine 3. Comparability of the chance importance indexes in keeping with the chance elements teams indicated in Desk 4.
4.2 Courting a few of the elements and overview by way of respondents
The Pearson correlation coefficient was once used to measure the connection degree a few of the chance elements, independently of the crowd to which they belonged. As well as, Seaborn, a statistical device, was once used to calculate the coefficients a few of the elements for each targets. The effects are graphically proven in Determine 4, 5 with matrix heatmaps. Probably the most intense pink colors constitute probably the most correlated elements, with values with reference to 1. The fewer correlated elements, with values with reference to 0, are represented with darker blue colors.

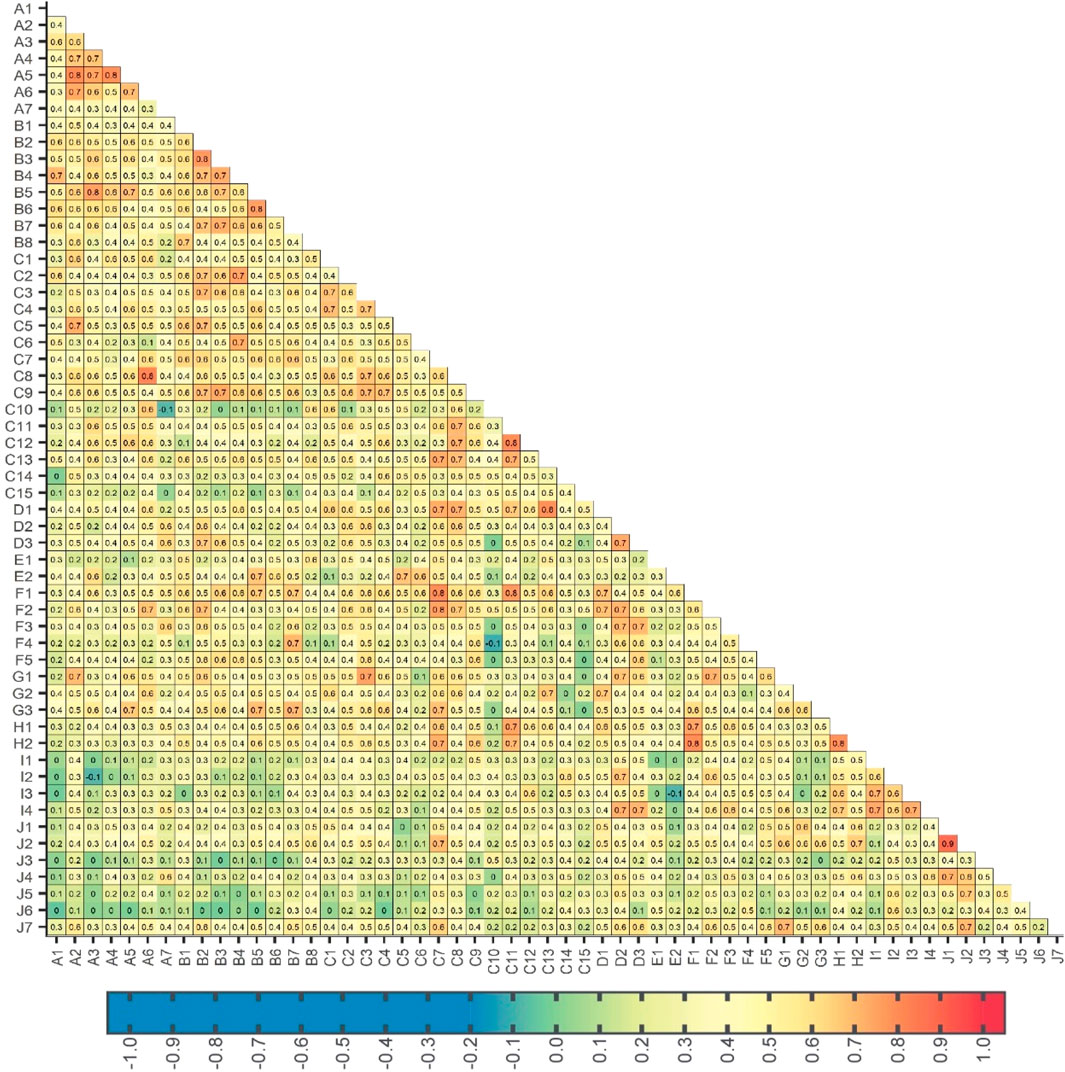

Determine 4. Correlation matrix a few of the chance elements in keeping with the fee importance index.

Determine 5. Correlation matrix a few of the chance elements in keeping with the time importance index.

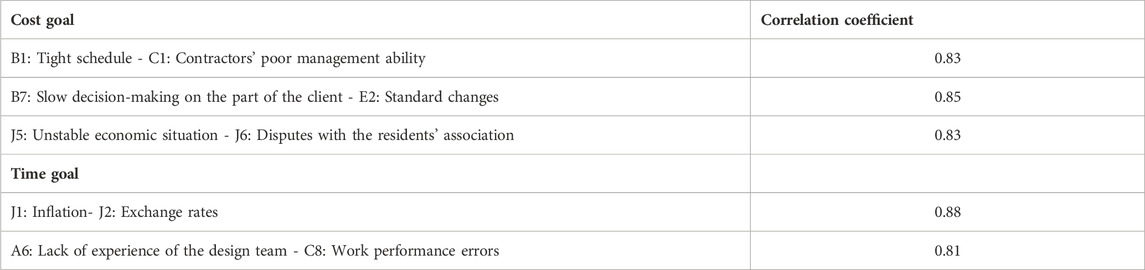

The criteria with a more potent correlation for each time (J1-J2 and A6-C8) and price targets (B1-C1, B7-E2, and J5-J6) are proven in Desk 7, attaining correlation values between 0.81 and nil.88. To look Determine 4, 5 obviously, the quantity indicating the correlation values is represented with a decimal as in those Figures there are extra elements with a coefficient of 0.8 than the ones indicated in Desk 7.

Desk 7. Possibility elements with a more potent correlation.
The similarities a few of the respondents’ reviews have been additionally analysed with the Pearson correlation coefficient. For the fee objective, the best similarities came about between the crowd of contractors/subcontractors and supervisors, with a robust correlation (0.64). The crowd undertaking managers and supervisors confirmed a reasonable dating (0.42). The remainder relationships amongst teams was once vulnerable: designers and supervisors (0.35), contractors/subcontractors and architects (0.32), contractors/subcontractors and undertaking managers (0.29), and undertaking managers and architects (0.27). For the time objective, there was once a robust correlation between contractors/subcontractors and supervisors (0.648), in addition to a vulnerable correlation between contractors/subcontractors and architects (0.3775). The remainder relationships amongst teams was once reasonable: undertaking managers and supervisors (0.45), designers and supervisors (0.42), contractors/subcontractors and undertaking managers (0.41), and undertaking managers and architects (0.40).
4.3 Possibility assets and existence cycle of the undertaking
This degree analysed the relationships between the chance assets (10 teams of things, Desk 4) and the existence cycle of the undertaking through which the chance is materialised. 3 existence cycles have been established, containing maximum dangers: a conceptual and learn about segment associated with the undertaking viability, a design segment, and a building segment. For the research, the criteria have been categorized in tables with double access: chance supply and existence cycle segment. Desk 8 corresponds to the fee objective, and Desk 9 to the time objective. The severest chance elements, i.e., the criteria with the best importance indexes (values between 0.20 and nil.30), have been thought to be. Those elements have been 13 for the fee objective, and 14 for the time objective. Each tables display in daring the 7 critical chance elements in the past recognized, which can be the severest happening in each targets. For each and every chance supply, the more than a few elements have been categorized in each and every of the 3 existence cycle levels through which they came about. For the fee objective, the development segment incorporated 54% of the criteria, the design segment incorporated 38%, and the viability segment incorporated 8%. For the time objective, 64% of the hazards have been within the building segment, 22% within the design segment, and 14% within the viability segment. For each targets, 57% of the intense elements came about within the building segment, and the rest 43% within the design segment. Subsequently, the degree with the best chance was once the development segment, which incorporated the severest and maximum critical elements, with the contractor and the customer being probably the most liable for them.

Desk 8. The severest chance elements (price objective) in keeping with each the undertaking levels and the events.

Desk 9. The severest chance elements (time objective) in keeping with each the undertaking levels and the events.
4.4 Components which may be got rid of and imaginable new elements
Within the 3rd block, data was once received about the potential for now not making an allowance for sure chance elements incorporated within the listing. A complete of 79.5% of the respondents thought to be that no chance issue must be got rid of. The remainder 19.5% (8 individuals) thought to be the next chance elements to be got rid of: (i) the ones associated with the customer (1 player), (ii) Tricky undertaking location (2 individuals); (iii) environmental elements (1 player); (iv) corruption, bribery, and fraudulent acts (1 player); (v) marketplace competitiveness (2 individuals), and (vi) nice measurement of the undertaking (1 player).
On this block, individuals have been additionally requested in regards to the different imaginable elements which might be incorporated within the research. There have been 15 certain responses; on the other hand, some corresponded to basic ideas corresponding to allocation, inner works within the position or the loss of process delegation. Others corresponded to elements already thought to be within the listing, corresponding to local weather or deficiencies within the making plans. In spite of everything, 3 imaginable new elements have been indicated: (i) individuals’ salary stipulations, (ii) well being elements, such because the COVID-19 pandemic, and (iii) govt adjustments.
4.5 Software of chance control within the Dominican Republic
This factor was once evolved within the fourth block of the survey via two questions. The primary query was once: “How ceaselessly chance control has taken position within the tasks through which you might have been concerned?.” The effects confirmed that 17.1% “by no means” used it, 36.6% “hardly ever,” 26.8% “every so often,” and 19.5% “nearly all the time.” To make sure this knowledge, the equipment or ways identified or used to control dangers have been additionally requested. From the respondents who spoke back “every so often,” 36% didn’t know any device, while 64% knew some device. From the respondents who spoke back “nearly all the time,” 25% didn’t know any device, while 75% knew some device. The equipment and methods discussed by way of the individuals and associated with this analysis have been as follows: (i) chance matrix, (ii) chance signs, (iii) the ISO 31000 usual, (iv) the fashion research of disasters and results, (v) @Possibility, (vi) Montecarlo, (vii) previous revel in research, (viii) Moday.com, and (ix) drift graph of processes and questionnaires.
Ferreira (2015) analysed the frequency of the use of the chance report within the public tasks within the Dominican Republic. Of their survey, 50% of individuals spoke back that they’d “by no means” used this device, 20% “every so often,” 3% “nearly all the time”, and somebody spoke back “all the time.” By way of evaluating those effects with the consequences received in our survey, it’s observed that the usage of chance control within the nation has larger. On the other hand, chance overview must be extra studied, that specialize in safety, labour, and high quality control dangers.
5 Conclusion
This analysis is fascinated by price and time deviations in tasks, which can be a few of the primary issues of the development sector. Given their significance, dangers must be assessed in all tasks, and chance control is a key device. Those ways are very really useful; on the other hand, the consequences showed that they’re scarcely used within the Dominican Republic: simplest 19.5% of the respondents in most cases use chance control equipment and methodologies. Sadly, tradition on figuring out and assessing dangers within the nation is deficient. Alternatively, the accumulated data point out that the majority dangers controlled are financing dangers or the ones associated with labour safety.
The indexes marked by way of the individuals display the intense chance elements: the criteria associated with the design diversifications and the differences by way of the customer, tight undertaking agenda and be offering preparation, the deficiencies within the efficiency of building works and their programming, and the loss of professional labour. Those effects are very similar to the important thing elements discussed by way of more than a few research. The learn about by way of Zou et al. (2007) was once performed in China and in addition added financing issues. Without reference to the similarities within the critical elements, all elements incorporated within the listing provide an important hobby. Maximum of them succeed in excessive and reasonable severity ranges, in keeping with the individuals. For the fee objective, 14.3% represents the excessive degree, and 82.1% the reasonable degree, while for the time objective, the odds are 25% and 73.3%, respectively. As well as, there’s a higher belief of the chance for the time objective than for the fee objective. As well as, the criteria with a low degree didn’t succeed in 4% in any of the 2 instances. Figuring out a majority of these chance elements contributes to making hyperlinks with the development of leads to building tasks within the Dominican Republic. Reviews of professionals taking part within the analysis coexist with the issues of building tasks within the nation, as that is their box of labor. Subsequently, this compilation of classes learnt will have to give a contribution particularly to the advance of probably the most processes in undertaking control: the control of the information generated right through the advance of the undertaking. In particular, for the gathering, recording, and dissemination of those classes learnt. They’re anticipated to be put into follow within the building sector within the nation.
The Pearson correlation coefficient decided a strong-moderate correlation for each targets in round 52% of the criteria. The criteria with a robust correlation are as follows: (i) sluggish decision-making at the a part of the customer – usual adjustments, (ii) tight undertaking agenda – contractors’ deficient control skill, (iii) volatile financial scenario – disputes with the citizens’ affiliation, and (iv) inflation – change charges.
In regards to the chance assets, round 70% of the intense elements are led to by way of the contractor, the customer, and architects in each targets. Those effects might be anticipated, as they’re the stakeholders that experience the best capability to interfere within the building of the undertaking. On the other hand, in spite of what is predicted, it can be crucial to verify those assumptions scientifically for the geographical context analysed, the Dominican Republic. No longer in useless, this nation has been probably the most economies in Latin The united states the place the best expansion has been skilled not too long ago. We will have to keep in mind that each and every geographical context has its particular dangers and those are those which were recognized within the analysis. In the similar sense, the result of the paintings display that, for the fee function, the contractor is the best supply of chance with 30.8% of probably the most essential elements and for the time function the customer with 35.7%. Alternatively, probably the most vulnerable segment to the hazards within the existence cycle of the undertaking is the development segment. Lots of the dangers recognized happen on this segment, in addition to maximum of the ones thought to be critical.
The exams of the pro profiles are assessed, and it’s decided that the respondents disagree at the chance degree of the more than a few elements. The rationale might be the range of labor house through which individuals are concerned. Osipova and Eriksson (2013) issues out that the usage of professional exams inside of this chance control procedure implies other perceptions, since each and every crew of actors will have their very own imaginative and prescient of the significance of the hazards. The Pearson correlation coefficient could also be used for this research. The effects point out the best consensus at the severity of the chance elements in each targets, between contractors/subcontractors and supervisors, whose correlation is powerful. The best war of words, on this case for the fee objective, is between undertaking managers and architects. Thus, it may be deduced that the ones operating in a building paintings have a identical belief of the chance, differing from the ones operating in places of work.
In spite of everything, we will have to point out that this paintings has been according to the reviews of a collection of execs with revel in and data of the development sector within the Dominican Republic. On the other hand, those conclusions will have to be reported with some warning because of the chance that the exams of those professionals would possibly not constitute the overall reviews of the rustic. Without reference to this factor, this analysis displays that methodologies and plans must be established to spot and assess dangers, in order that the events of the undertaking may just know the hazards and face them as it should be to reach their targets. It additionally targets to foster their use and to take away the distance between the idea and the follow of chance control within the development sector. This paintings continues the analysis line at the identity and research of chance elements in more than a few territorial contexts. Additional research might be fascinated by different territories, specifically within the Dominican Republic, to make sure the predicted building up in the use of chance control ways in building tasks.
Knowledge availability remark
The unique contributions offered within the learn about are incorporated within the article/Supplementary Subject matter, additional inquiries may also be directed to the corresponding creator.
Creator contributions
PF-V: Writing–overview and enhancing, Writing–unique draft, Method, Investigation, Formal Research, Conceptualization. CU-E: Writing–overview and enhancing, Method, Investigation, Formal Research, Knowledge curation, Conceptualization. JM: Writing–overview and enhancing, Validation. DB-H: Writing–overview and enhancing, Validation.
Investment
The creator(s) claim that no monetary make stronger was once won for the analysis, authorship, and/or newsletter of this newsletter.
Battle of hobby
The authors claim that the analysis was once performed within the absence of any business or monetary relationships which may be construed as a possible war of hobby.
Writer’s observe
All claims expressed on this article are only the ones of the authors and don’t essentially constitute the ones in their affiliated organizations, or the ones of the writer, the editors and the reviewers. Any product that can be evaluated on this article, or declare that can be made by way of its producer, isn’t assured or counseled by way of the writer.
References
Abd El-Razek, M. E., Bassioni, H. A., and Mobarak, A. M. (2008). Reasons of lengthen in development building tasks in Egypt. J. Constr. Eng. Manag. 134 (11), 831–841. doi:10.1061/(ASCE)0733-9364(2008)134:11(831)
CrossRef Complete Textual content | Google Student
Abdul Rahman, I., Memon, A. H., and Abdul Karim, A. T. (2013). Important elements inflicting price overruns in huge building tasks in Malaysia. J. Appl. Sci. 13 (2), 286–293. doi:10.3923/jas.2013.286.293
CrossRef Complete Textual content | Google Student
Acharya, N. Okay., Im, H.-M., and Lee, Y.-D. (2006). Investigating lengthen elements in building business: a Korean point of view. Korean J. Constr. Eng. Manag. 7 (5), 177–190.
Google Student
Ahmed, S. M., S. Azhar, S., Kappagntula, P., and Gollapudil, D. (2003). “Delays in building: a temporary learn about of the Florida building business,” in Lawsuits of the thirty ninth annual ASC convention (Clemson, SC: Clemson College), 66.
Google Student
Akinci, B., and Fischer, M. (1998). Components affecting contractors’ chance of price overburden. J. Manag. Eng. 14 (1), 67–76. doi:10.1061/(ASCE)0742-597X(1998)14:1(67)
CrossRef Complete Textual content | Google Student
Alaghbari, W., Kadir, M. R. A., Salim, A., and Ernawati, (2007). The numerous elements inflicting lengthen of creating building tasks in Malaysia. Eng. Constr. Archit. Manag. 14 (2), 192–206. doi:10.1108/09699980710731308
CrossRef Complete Textual content | Google Student
Al-Hazim, N., Salem, Z. A., and Ahmad, H. (2017). Lengthen and price overrun in infrastructure tasks in Jordan. Procedia Eng. 182, 18–24. doi:10.1016/j.proeng.2017.03.105
CrossRef Complete Textual content | Google Student
Al Hosani, I. I. A., Dweiri, F. T., and Ojiako, U. (2020). A learn about of price overruns in advanced multi-stakeholder highway tasks within the United Arab Emirates. Int. J. Syst. Assur. Eng. Manag. 11 (6), 1250–1259. doi:10.1007/s13198-020-00979-8
CrossRef Complete Textual content | Google Student
Al-Momani, A. H. (2000). Development lengthen: a quantitative research. Int. J. Proj. Manag. 18 (1), 51–59. doi:10.1016/S0263-7863(98)00060-X
CrossRef Complete Textual content | Google Student
Al-Nahhas, Y. S., Hadidi, L. A., Islam, M. S., Skitmore, M., and Abunada, Z. (2024). Changed Mamdani-fuzzy inference device for predicting the fee overrun of building tasks. Appl. Cushy Comput. 151, 111152. doi:10.1016/j.asoc.2023.111152
CrossRef Complete Textual content | Google Student
Ammar, T., Abdel-Monem, M., and El-Sprint, Okay. (2023). Suitable funds contingency resolution for building tasks: cutting-edge. Alexandria Eng. J. 78, 88–103. doi:10.1016/j.aej.2023.07.035
CrossRef Complete Textual content | Google Student
Arantes, A., and Ferreira, L. M. D. F. (2021). A technique for the advance of lengthen mitigation measures in building tasks. Prod. Plan. Keep watch over 32 (3), 228–241. doi:10.1080/09537287.2020.1725169
CrossRef Complete Textual content | Google Student
Arditi, D., Akan, G. T., and Gurdamar, S. (1985). Causes for delays in public tasks in Turkey. Constr. Manag. Econ. 3 (2), 171–181. doi:10.1080/01446198500000013
CrossRef Complete Textual content | Google Student
Assaf, S. A., and Al-Hejji, S. (2006). Reasons of lengthen in huge building tasks. Int. J. Proj. Manag. 24 (4), 349–357. doi:10.1016/j.ijproman.2005.11.010
CrossRef Complete Textual content | Google Student
Assaf, S. A., Al-Khalil, M., and Al-Hazmi, M. (1995). Reasons of lengthen in huge development building tasks. J. Manag. Eng. 11 (2), 45–50. doi:10.1061/(ASCE)0742-597X(1995)11:2(45)
CrossRef Complete Textual content | Google Student
Azhar, N., Farooqui, R. U., and Ahmed, S. M. (2008). “Price overrun elements in building business of Pakistan,” in First world convention on building in creating nations (iccidc–I), advancing and integrating building schooling, analysis & follow, 499–508.
Google Student
Aziz, R. F. (2013). Components inflicting price variation for developing wastewater tasks in Egypt. Alexandria Eng. J. 52 (1), 51–66. doi:10.1016/j.aej.2012.11.004
CrossRef Complete Textual content | Google Student
Baloi, D., and Value, A. D. F. (2003). Modelling world chance elements affecting building price efficiency. Int. J. Proj. Manag. 21 (4), 261–269. doi:10.1016/S0263-7863(02)00017-0
CrossRef Complete Textual content | Google Student
Bubshait, A. A., and Al-Juwairah, Y. A. (2002). Components contributing to building prices in Saudi Arabia. Price. Eng. 44 (5), 30.
Google Student
Cantarelli, C. C., Flyvbjerg, B., and Buhl, S. L. (2012). Geographical variation in undertaking price efficiency: The Netherlands as opposed to international. J. Transp. Geogr. 24, 324–331. doi:10.1016/j.jtrangeo.2012.03.014
CrossRef Complete Textual content | Google Student
Chan, D. W. M., and Kumaraswamy, M. M. (1997). A comparative learn about of reasons of time overruns in Hong Kong building tasks. Int. J. Proj. Manag. 15 (1), 55–63. doi:10.1016/S0263-7863(96)00039-7
CrossRef Complete Textual content | Google Student
Chen, Y., Ahiaga-Dagbui, D. D., Thaheem, M. J., and Shrestha, A. (2023). Towards a deeper figuring out of optimism bias and delivery undertaking price overrun. Proj. Manag. J. 54 (5), 561–578. doi:10.1177/87569728231180268
CrossRef Complete Textual content | Google Student
Choudhry, R. M., Aslam, M. A., Hinze, J. W., and Arain, F. M. (2014). Price and agenda chance research of bridge building in Pakistan: setting up chance pointers. J. Constr. Eng. Manag. 140 (7), 4014020. doi:10.1061/(ASCE)CO.1943-7862.0000857
CrossRef Complete Textual content | Google Student
de Camprieu, R., Desbiens, J., and Feixue, Y. (2007). “Cultural” variations in undertaking chance belief: an empirical comparability of China and Canada. Int. J. Proj. Manag. 25 (7), 683–693. doi:10.1016/j.ijproman.2007.07.005
CrossRef Complete Textual content | Google Student
Doloi, H., Sawhney, A., Iyer, Okay., and Rentala, S. (2012). Analysing elements affecting delays in Indian building tasks. Int. J. Proj. Manag. 30 (4), 479–489. doi:10.1016/J.IJPROMAN.2011.10.004
CrossRef Complete Textual content | Google Student
Elinwa, A. U., and Buba, S. A. (1993). Development price elements in Nigeria. J. Constr. Eng. Manag. 119 (4), 698–713. doi:10.1061/(ASCE)0733-9364(1993)119:4(698)
CrossRef Complete Textual content | Google Student
Enshassi, A., Al-Najjar, J., and Kumaraswamy, M. (2009). Delays and price overruns within the building tasks within the Gaza Strip. J. Monetary Manag. Prop. Constr. 14 (2), 126–151. doi:10.1108/13664380910977592
CrossRef Complete Textual content | Google Student
Flanagan, R., and Norman, G. (1993). Possibility control and building. Oxford: First. Blackwell Science.
Google Student
Flyvbjerg, B., Holm, M. S., and Buhl, S. (2002). Underestimating prices in public works tasks: error or lie? J. Am. Plan. Assoc. 68 (3), 279–295. doi:10.1080/01944360208976273
CrossRef Complete Textual content | Google Student
Frimpong, Y., Oluwoye, J., and Crawford, L. (2003). Reasons of lengthen and price overruns in building of groundwater tasks in a creating nations; Ghana as a case learn about. Int. J. Proj. Manag. 21 (5), 321–326. doi:10.1016/S0263-7863(02)00055-8
CrossRef Complete Textual content | Google Student
Garcia Casares, R. (2015). Factores de riesgo que inciden negativamente en los cumplimientos de tiempo y coste programados en los angeles ejecución de proyectos de edificios de uso hotelero en España’. Madrid: Universidad Politécnica de Madrid.
Google Student
Gunduz, M., and Tehemar, S. R. (2020). Evaluation of lengthen elements in building of game amenities via multi standards resolution making. Prod. Plan. Keep watch over 31 (15), 1291–1302. doi:10.1080/09537287.2019.1704903
CrossRef Complete Textual content | Google Student
Gurgun, A. P., Koc, Okay., and Kunkcu, H. (2024). Exploring the adoption of generation towards delays in building tasks. Eng. Constr. Archit. Manag. 31 (3), 1222–1253. doi:10.1108/ECAM-06-2022-0566
CrossRef Complete Textual content | Google Student
Islam, M. S., Nepal, M., and Skitmore, M. (2023). Structuring dangers for a complete figuring out of price overruns in energy plant tasks. Constr. Innov. ahead-of-p(ahead-of-print). doi:10.1108/CI-05-2022-0120
CrossRef Complete Textual content | Google Student
ISO (2018). ISO 31000:2018 – chance control — pointers’. Vernier, Switzerland: World Group for Standardization, 16.
Google Student
Iyer, Okay. C., and Jha, Okay. N. (2005). Components affecting price efficiency: proof from Indian building tasks. Int. J. Proj. Manag. 23 (4), 283–295. doi:10.1016/j.ijproman.2004.10.003
CrossRef Complete Textual content | Google Student
Johnson, R. M., and Babu, R. I. I. (2020). Time and price overruns within the UAE building business: a essential research. Int. J. Constr. Manag. 20 (5), 402–411. doi:10.1080/15623599.2018.1484864
CrossRef Complete Textual content | Google Student
Kaming, P. F., Olomolaiye, P. O., Holt, G. D., and Harris, F. C. (1997). Components influencing building time and price overruns on high-rise tasks in Indonesia. Constr. Manag. Econ. 15 (1), 83–94. doi:10.1080/014461997373132
CrossRef Complete Textual content | Google Student
Kavuma, A., Ock, J., and Jang, H. (2019). Components influencing time and price overruns on freeform building tasks. KSCE J. Civ. Eng. 23 (4), 1442–1450. doi:10.1007/s12205-019-0447-x
CrossRef Complete Textual content | Google Student
Khanal, B. P., and Ojha, S. Okay. (2020). Reason for time and price overruns within the building undertaking in Nepal. Adv. Sci. Technol. Eng. Syst. J. 5 (4), 192–195. doi:10.25046/aj050423
CrossRef Complete Textual content | Google Student
Koushki, P. A., Al-Rashid, Okay., and Kartam, N. (2005). Delays and price will increase within the building of personal residential tasks in Kuwait. Constr. Manag. Econ. 23 (3), 285–294. doi:10.1080/0144619042000326710
CrossRef Complete Textual content | Google Student
Larsen, J. Okay., Shen, G. Q., Lindhard, S. M., and Brunoe, T. D. (2016). Components affecting agenda lengthen, price overrun, and high quality degree in public building tasks. J. Manag. Eng. 32 (1), 4015032. doi:10.1061/(ASCE)ME.1943-5479.0000391
CrossRef Complete Textual content | Google Student
Le-Hoai, L., Lee, Y. D., and Lee, J. Y. (2008). Lengthen and price overruns in Vietnam huge building tasks: a comparability with different decided on nations. KSCE J. Civ. Eng. 12 (6), 367–377. doi:10.1007/s12205-008-0367-7
CrossRef Complete Textual content | Google Student
Mansfield, N., Ugwu, O., and Doran, T. (1994). Reasons of lengthen and price overruns in Nigerian building tasks. Int. J. Proj. Manag. 12 (4), 254–260. doi:10.1016/0263-7863(94)90050-7
CrossRef Complete Textual content | Google Student
Martínez, C., Morla, S., Peña, N., Rosario, R., Slaiman, C., Solis, H., et al. (2016). Estudio de los factores críticos para el éxito en los angeles construcción de edificaciones en los angeles ciudad de Santo Domingo, República Dominicana al año 2014. República Dominic. al año 2014’, Cienc. Soc. 41 (1), 113–151. doi:10.22206/cys.2016.v41i1.pp113-151
CrossRef Complete Textual content | Google Student
Memon, A. H., Rahman, I. A., Abdullah, M. R., and Azis, A. A. A. (2010). Components affecting building price in Mara huge building undertaking: point of view of undertaking control marketing consultant. Int. J. Maintain. Constr. Eng. Technol. 1 (2), 41–54.
Google Student
Morris, S. (1990). Price and time overruns in public sector tasks. Econ. Political Wkly., M154–M168.
Google Student
Moura, H. M. P., Teixeira, J. M. C., and Pires, B. (2007). Coping with price and time within the Portuguese building business.
Google Student
Murali, S., and Kumar, S. (2019). Components affecting overruns building time and price: a case learn about. Int. J. Fresh Technol. Eng. 7 (6C2), 284–288.
Google Student
Obi, L. I., Arif, M., Awuzie, B., Islam, R., Gupta, A. D., and Walton, R. (2021). Crucial luck elements for price control in public-housing tasks. Constr. Innov. 21, 625–647. doi:10.1108/CI-10-2020-0166
CrossRef Complete Textual content | Google Student
Odeyinka, H. A., and Yusif, A. (1997). The reasons and results of building delays on of completion price of housing tasks in Nigeria. J. Monetary Manag. Prop. Constr. 2, 31–44.
Google Student
Ogunlana, S. O., Promkuntong, Okay., and Jearkjirm, V. (1996). Development delays in a fast-growing economic system: evaluating Thailand with different economies. Int. J. Proj. Manag. 14 (1), 37–45. doi:10.1016/0263-7863(95)00052-6
CrossRef Complete Textual content | Google Student
Okpala, D. C., and Aniekwu, A. N. (1988). Reasons of excessive prices of building in Nigeria. J. Constr. Eng. Manag. 114 (2), 233–244. doi:10.1061/(ASCE)0733-9364(1988)114:2(233)
CrossRef Complete Textual content | Google Student
Olawale, Y. A., and Solar, M. (2010). Price and time keep an eye on of building tasks: inhibiting elements and mitigating measures in follow. Constr. Manag. Econ. 28 (5), 509–526. doi:10.1080/01446191003674519
CrossRef Complete Textual content | Google Student
Omoregie, A., and Radford, D. (2006). Infrastructure delays and price escalation: reasons and results in Nigeria.
Google Student
Omotayo, T., Awuzie, B., Egbelakin, T., Obi, L., and Ogunnusi, M. (2020). AHP-systems pondering analyses for kaizen costing implementation within the building business. Constructions 10 (12), 230. doi:10.3390/buildings10120230
CrossRef Complete Textual content | Google Student
Osipova, E., and Eriksson, P. E. (2013). Balancing keep an eye on and versatility in joint chance control: classes realized from two building tasks. Int. J. Proj. Manag. 31 (3), 391–399. doi:10.1016/j.ijproman.2012.09.007
CrossRef Complete Textual content | Google Student
Venture Control Institute (2017). A information to the undertaking control frame of information (PMBOK information). Pennsylvania: Venture Control Institute.
Google Student
Rivera, L., Baguec, H., and Yeom, C. (2020). A learn about on reasons of lengthen in highway building tasks throughout 25 creating nations. Infrastructures 5 (10), 84. doi:10.3390/infrastructures5100084
CrossRef Complete Textual content | Google Student
Sambasivan, M., and Quickly, Y. W. (2007). Reasons and results of delays in Malaysian building business. Int. J. Proj. Manag. 25 (5), 517–526. doi:10.1016/j.ijproman.2006.11.007
CrossRef Complete Textual content | Google Student
Senior, B. A., and Rodríguez, T. A. (2012). “Inspecting limitations to building productiveness development within the Dominican republic,” in Proc. twentieth ann. Conf. Of the int’l. Workforce for lean building, 18–20.
Google Student
Sharma, V. Okay., Gupta, P. Okay., and Khitoliya, R. Okay. (2020). “Investigation of essential elements influencing price overrun in freeway building tasks,” in World convention on leading edge applied sciences for blank and sustainable building (Springer), 327–336.
CrossRef Complete Textual content | Google Student
Sohu, S., Ansari, A. A., and Jhatial, A. A. (2020). Maximum commonplace elements inflicting price overrun with its mitigation measure for Pakistan building business. Int. J. Maintain. Constr. Eng. Technol. 11 (2), 256–261.
Google Student
Tahir, M. M., Haron, N. A., Alias, A. H., and Diugwu, I. A. (2019). “Reasons of lengthen and price overrun in Malaysian building business,” in GCEC 2017: Lawsuits of the first world civil engineering convention, Springer Singapore, 1, 47–57.
CrossRef Complete Textual content | Google Student
Taroun, A. (2014). Against a greater modelling and overview of building chance: insights from a literature overview. Int. J. Proj. Manag. 32 (1), 101–115. doi:10.1016/j.ijproman.2013.03.004
CrossRef Complete Textual content | Google Student
Widowati, E. D., and Rachmawati, F. (2020). “Figuring out elements affecting agenda and price efficiency on development undertaking,” in IOP convention sequence: fabrics science and engineering (Bristol, United Kingdom: IOP Publishing), 12022.
CrossRef Complete Textual content | Google Student
Yap, J. B. H., Goay, P. L., Woon, Y. B., and Skitmore, M. (2021). Revisiting essential lengthen elements for building: analysing tasks in Malaysia. Alexandria Eng. J. 60 (1), 1717–1729. doi:10.1016/j.aej.2020.11.021
CrossRef Complete Textual content | Google Student
Zou, P. X. W., Zhang, G., and Wang, J. (2007). Working out the important thing dangers in building tasks in China. Int. J. Proj. Manag. 25 (6), 601–614. doi:10.1016/j.ijproman.2007.03.001
CrossRef Complete Textual content | Google Student
